Exceptions ​

Exceptions is the PMO's "what needs attention" list: every live project that breaks at least one rule, with each reason linked to the record it is about.

Exceptions

Who can use it ​

Everyone who can open the screen sees the projects they are allowed to see. A reason that needs a permission you do not hold (for example payment.view for invoice rules) is not shown or counted for you.

Live projects means active and not Completed or Cancelled.

Reading the page ​

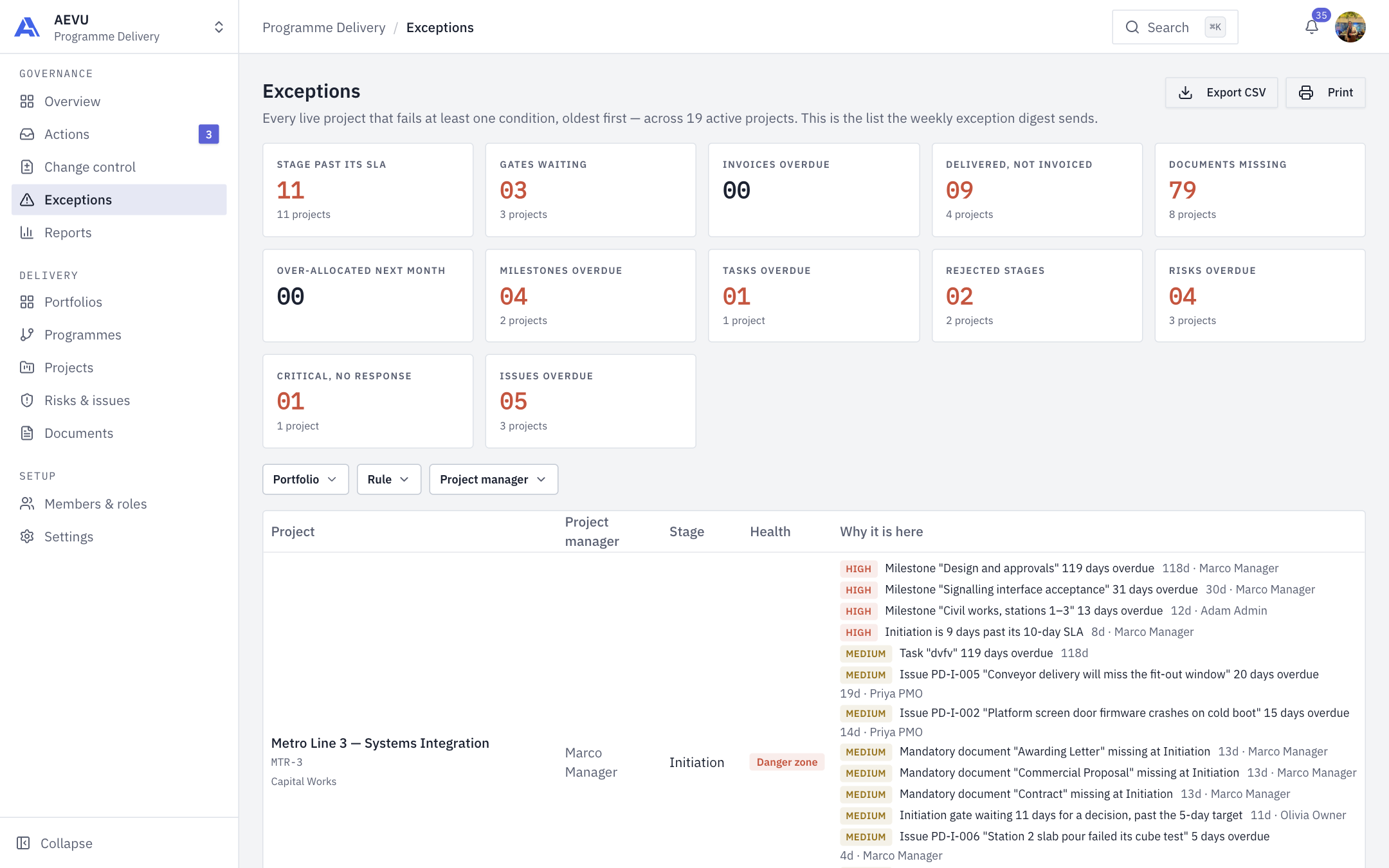

  • Tiles: one per rule with its count. The headline tiles (stage SLA, gates, invoices overdue, documents missing, over 100%) always show; others only when they have items. Click a tile to filter by that rule.
  • Filters: portfolio, rule and project manager. They are remembered in your browser.
  • Table (oldest first): Project, Project manager, Stage, Health, and Why it is here (severity, a link to the record, age in days and owner). Fifty projects per page.
  • Each row shows the three most severe reasons per rule and "and N more" for the rest.

The rules ​

RuleFires when
Stage past its SLAThe current stage is open and past the SLA set in Settings. No SLA, never fires
Past planned finishThe project's end date is before today
Gates waitingA stage has been waiting for PMO approval 5 or more days
Rejected stagesThe current stage was returned
No managerThe project has no project manager
Milestones overdueAn open milestone's due date is before today
Tasks overdueAn open task's due date is before today (medium severity from 30 days late)
Delivered, not invoicedA completed milestone that bills the client has no invoice date
Invoices overdueAn invoiced, unpaid milestone is past the project's payment terms
Documents missingA mandatory document for the current stage is missing once the gate is at stake (submitted, rejected, or past its SLA)
Delivery notes unsignedThe stage requires signed delivery notes and a billed milestone has none signed
Over-allocated next monthA person is booked above 100% next calendar month
Risks overdueAn open risk's due date is before today
Critical, no responseAn open Critical risk has no response type
Issues overdueAn open issue's due date is before today

"Due today" is never late. An open risk is one not yet Mitigated or Closed.

Export and print ​

  • Export CSV gives one row per reason, including those the page collapses.
  • Print (next to Export CSV) prints a clean copy of the page; choose Save as PDF in the print dialog to keep one.

Weekly digest ​

By default every Monday at 08:00 Gulf time (04:00 UTC), when the workspace's Weekly exception digest switch is on, people with gate.approve get an email, "what needs you this week": gates waiting, projects past baseline, overdue invoices, documents missing and people over 100%. A week with nothing is not mailed.
